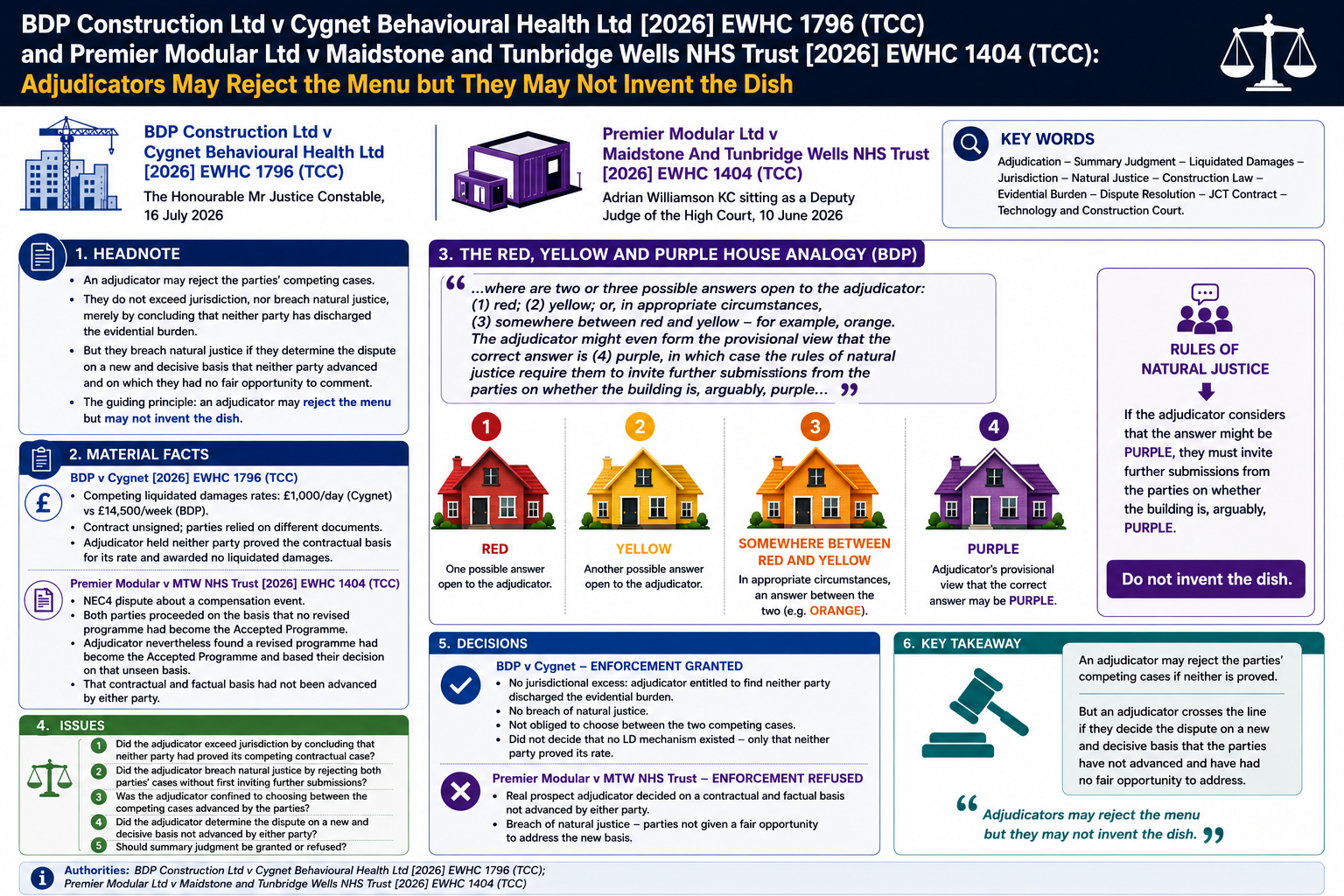

BDP Construction Ltd v Cygnet Behavioural Health Ltd [2026] EWHC 1796 (TCC)
The Honourable Mr Justice Constable, 16 July 2026
Premier Modular Ltd v Maidstone And Tunbridge Wells NHS Trust [2026] EWHC 1404 (TCC)
Adrian Williamson KC sitting as a Deputy Judge of the High Court, 10 June 2026
Key Words
Adjudication – Summary Judgment – Liquidated Damages – Jurisdiction – Natural Justice – Construction Law – Evidential Burden – Dispute Resolution – JCT Contract – Technology and Construction Court.
- Headnote
- These cases concerned the limits of adjudicator decision-making and the circumstances in which allegations of jurisdictional excess or breach of natural justice prevented, or failed to prevent, enforcement of adjudicators’ decisions. [B20]-[B22], [B23]-[B40]; [P42], [P48]-[P50]
- In BDP Construction Ltd v Cygnet Behavioural Health Ltd, the Court enforced an adjudicator’s decision where the adjudicator concluded that neither party had established the contractual basis for its competing liquidated damages case. [B18]-[B19], [B27]-[B30], [B40]
- The Court held that an adjudicator did not exceed jurisdiction, nor breach natural justice, merely by concluding that neither party had discharged the evidential burden in relation to the competing cases advanced. [B27]-[B30], [B34], [B40]
- A notable feature of the judgment was the Court’s adoption of the “red, yellow and purple house” analogy when addressing the jurisdiction challenge. [B23]-[B24]
- The Court rejected the submission that the adjudicator had effectively determined that no liquidated damages mechanism existed. The Court held that the adjudicator had merely concluded that neither party had persuaded him that the applicable liquidated damages rate was the rate for which that party contended. [B24], [B30]
- The Court further held that the existence of only two competing contractual cases did not oblige the adjudicator to select one of them. The adjudicator remained entitled to conclude that neither side had proved its case. [B25]-[B30]
- In Premier Modular Ltd v Maidstone and Tunbridge Wells NHS Trust, the Court refused summary enforcement because the Trust had a real prospect of establishing that the adjudicator had determined the dispute upon a contractual and factual basis that neither party had advanced and which had not been fairly canvassed. [P35], [P39(ii)]-[P39(iv)], [P42], [P48]-[P51]
- The combined effect of the judgments was that an adjudicator remained entitled to reject the parties’ competing cases but risked a material breach of natural justice if the dispute was determined upon a new and decisive basis which neither party had advanced and upon which the parties had not been given a fair opportunity to comment. [B30], [B34]; [P35], [P39(iv)], [P42]
- Material Facts
- In BDP Construction Ltd v Cygnet Behavioural Health Ltd, BDP was engaged by Cygnet under an amended JCT Design and Build Contract 2016 for the construction of a hospital development. [B1], [B4]
- Practical completion was achieved on 18 July 2024. [B4]
- Cygnet subsequently claimed £141,000 in liquidated damages calculated by reference to a completion date of 29 February 2024 and a liquidated damages rate of £1,000 per day. [B5]
- BDP disputed that claim and contended that the applicable contractual amendments provided for a completion date of 26 April 2024 and liquidated damages at the rate of £14,500 per week. [B8], [B12]-[B14]
- The contract had not been executed and the parties relied on different contractual documentation and different contemporaneous evidence to support their respective positions. [B8], [B12]-[B14], [B17]-[B18]
- The adjudicator concluded that neither party had established the contractual basis of its asserted liquidated damages rate and consequently determined that Cygnet was not entitled to recover liquidated damages. [B18]-[B19]
- BDP then sought summary judgment to enforce the adjudicator’s decision. [B1]-[B3]
- In Premier Modular Ltd v Maidstone and Tunbridge Wells NHS Trust, the claimant sought enforcement of an adjudicator’s award arising from an NEC4 compensation event dispute concerning the provision of a permanent mains water supply. [P11], [P13]
- Both parties had proceeded on the basis that no revised programme had become the Accepted Programme. [P14], [P25]
- The adjudicator nevertheless concluded that a revised programme had become the Accepted Programme and relied upon that conclusion to determine that a compensation event existed under clause 60.1(3). [P30]-[P31]
- That contractual and factual basis had not been advanced by either party. [P35], [P39(iv)], [P42]
- Issues
- Whether an adjudicator exceeded jurisdiction by concluding that neither party had proved its competing contractual case. [B23]-[B31]
- Whether an adjudicator breached natural justice by rejecting both parties’ cases without first inviting further submissions. [B32]-[B39]
- Whether an adjudicator was confined to choosing between two competing positions merely because the parties had framed the dispute as a binary dispute. [B25]-[B30]
- Whether a shared dispute concerning contractual rights was equivalent to a shared contractual premise restricting the adjudicator’s jurisdiction. [B21(2)], [B28]-[B30]
- Whether an adjudicator breached natural justice by determining a dispute on a contractual and factual basis not advanced by either party and not fairly canvassed during the adjudication. [P35], [P39(ii)]-[P39(iv)], [P42]
- Whether such conduct justified refusal of summary enforcement notwithstanding the court’s established policy of robust adjudication enforcement. [B20]; [P48]-[P50]
- Decision
- The Court enforced the adjudicator’s decision in BDP Construction Ltd v Cygnet Behavioural Health Ltd. [B40]
- The Court held that the adjudicator had acted within jurisdiction by determining that neither party had established its asserted liquidated damages regime. [B27]-[B30], [B40]
- The Court further held that the adjudicator had not breached natural justice because he had merely rejected evidence that had already been canvassed between the parties. [B34], [B40]
- The Court refused summary enforcement in Premier Modular Ltd v Maidstone and Tunbridge Wells NHS Trust. [P48]-[P51]
- The Court held that the Trust had a real prospect of establishing that the adjudicator had determined the dispute upon a contractual and factual basis which neither party had advanced and which had not been fairly canvassed. [P35], [P39(ii)]-[P39(iv)], [P42]
- The Court held that the defendant had a real prospect of establishing a material breach of natural justice. [P42], [P48]-[P50]
- Reasoning
- The Court in BDP reaffirmed that adjudicators’ decisions would ordinarily be enforced notwithstanding errors of fact or law unless the adjudicator exceeded jurisdiction or committed a material breach of natural justice. [B20]
- The Court rejected the submission that the adjudicator was confined to choosing between the two liquidated damages rates advanced by the parties. [B25]-[B30]
- The Court held that no agreement existed which restricted the adjudicator to a binary choice between £1,000 per day and £14,500 per week. [B25]-[B29]
- A significant feature of the judgment was the “red, yellow and purple house” analogy. Counsel submitted that where an adjudicator was asked to determine whether a building was red or yellow, the adjudicator might conclude that the building was red, yellow, orange, or even purple after inviting submissions, but could not conclude that the building itself did not exist. [B23]
- The Court rejected the submission that the adjudicator’s reasoning was equivalent to deciding that the building did not exist. [B24]
- The Court held that the adjudicator had not decided that no liquidated damages mechanism existed. The adjudicator had merely concluded that neither party had persuaded him that the applicable liquidated damages rate was the rate for which that party contended. [B24], [B30]
- The Court characterised the dispute as concerning the applicable completion date and applicable liquidated damages rate rather than the existence of a liquidated damages mechanism. [B24]
- The Court held that the existence of only two competing positions did not itself create a jurisdictional limitation requiring the adjudicator to choose one of them. [B25]-[B27]
- The Court held that BDP bore the burden of proving that its asserted rate of £14,500 per week formed part of the contract and that Cygnet bore an evidential burden in relation to its contention that the applicable rate was £1,000 per day. [B27]
- The Court further held that the failure of BDP to establish its case did not require a finding that Cygnet had successfully proved its own case. [B27]
- The Court reiterated that an adjudicator was ordinarily entitled to conclude that a party had failed to prove what it asserted. [B28]
- The Court reviewed authorities including Shimizu Europe Ltd v LBJ Fabrications Ltd and Primus Build Ltd v Pompey Centre Ltd concerning agreed factual or contractual premises. [B21(2)], [B28]
- The Court held that those authorities did not assist Cygnet because there was no agreed contractual premise in the present case. Neither party accepted the contractual case advanced by the other, even in the alternative. [B29]-[B30]
- The judgment therefore drew a clear distinction between a shared dispute and a shared premise. The parties shared a dispute concerning the applicable liquidated damages regime but did not share any agreed contractual basis upon which that dispute was to be determined. [B25]-[B30]
- The Court also gave detailed consideration to the natural justice challenge. [B32]-[B39]
- The Court held that an adjudicator did not breach natural justice merely by rejecting evidence that had already been placed before the adjudicator and debated by the parties. [B34]
- The Court distinguished between rejecting evidence already canvassed and deciding a dispute upon a new positive basis not advanced by either party. [B34]
- The former was permissible. The latter might require the adjudicator to invite further submissions before reaching a determination. [B23], [B34]
- Perhaps the most important practical observation appeared in paragraph 30. The Court observed that the adjudicator had effectively accepted BDP’s criticisms of Cygnet’s contractual case whilst simultaneously accepting Cygnet’s criticisms of BDP’s contractual case. [B30]
- The consequence was that both parties failed to establish the contractual foundation required for their respective positions. [B30]
- The Court therefore treated the adjudicator’s conclusion as an orthodox application of evidential burden and proof rather than a departure from the issues referred for determination. [B27]-[B30]
- Conversely, the Court in Premier Modular concluded that the adjudicator’s reasoning depended upon propositions not advanced by either party. [P35], [P42]
- The adjudicator’s conclusion that a revised programme had become the Accepted Programme formed the foundation of the compensation event finding notwithstanding that both parties had proceeded on the opposite basis. [P30]-[P35], [P42]
- The Court held that the adjudicator had effectively gone off on a “frolic” by deciding the dispute on an unargued basis not properly put to the parties. [P36], [P42]
- The Court therefore distinguished permissible independent reasoning from impermissible reliance upon a new and determinative contractual theory that had never formed part of either party’s case. [P35], [P39(iv)], [P42]
- Applicable Principles
- An adjudicator did not exceed jurisdiction merely because the adjudicator concluded that neither party had established the contractual or factual basis of its competing case. [B27]-[B30]
- An adjudicator was entitled to reject both parties’ submissions where the relevant evidence had been fully canvassed and the adjudicator was merely assessing whether the evidential burden had been discharged. [B28]-[B30], [B34]
- The existence of only two competing contractual cases did not require an adjudicator to select one of them. An adjudicator remained entitled to conclude that neither case had been established on the evidence. [B25]-[B30]
- A jurisdictional restriction arose only where the parties shared an agreed factual or contractual premise upon which the adjudicator was required to proceed. A shared dispute did not constitute a shared premise. [B21(2)], [B28]-[B30]
- An adjudicator did not breach natural justice merely by rejecting competing evidence already advanced and debated within the adjudication process. [B34]
- A material breach of natural justice may arise where an adjudicator decides the dispute upon a decisive contractual or factual basis not advanced by either party and not fairly canvassed, without first giving the parties an opportunity to comment. [P35], [P39(iv)], [P42]
- The distinction between rejecting the parties’ cases and creating a new case constituted the critical boundary between lawful adjudicator reasoning and material procedural unfairness. [B30], [B34]; [P35], [P39(iv)], [P42]
- Disposition
- In BDP Construction Ltd v Cygnet Behavioural Health Ltd, summary judgment was granted in favour of BDP in the sum of £136,769 together with £4,779 in adjudicator’s costs and interest. [B40]
- In Premier Modular Ltd v Maidstone and Tunbridge Wells NHS Trust, the claimant’s application for summary judgment was dismissed and the adjudicator’s decision was not summarily enforced. [P51]
- Summary of Holdings and Conclusions
- Held, that an adjudicator was not restricted to selecting one of two competing cases merely because the parties had framed the dispute in binary terms. [B25]-[B30]
- Held, that an adjudicator remained entitled to conclude that neither party had proved its case and that such a conclusion did not constitute either a jurisdictional excess or a breach of natural justice. [B27]-[B30], [B34], [B40]
- Held, that the adjudicator had not concluded that no liquidated damages mechanism existed, but had merely concluded that neither party had established the contractual rate of liquidated damages for which it contended. [B24], [B30]
- Held, that a shared dispute concerning contractual rights was not equivalent to a shared contractual premise restricting the adjudicator’s jurisdiction. [B28]-[B30]
- Held, that an adjudicator was entitled to accept each party’s criticisms of the other party’s contractual case and conclude that neither party had discharged the burden of proving its asserted position. [B30]
- Held, that an adjudicator did not breach natural justice by rejecting competing evidence already before the adjudicator, provided that the adjudicator did not determine the dispute on an unargued positive basis which had not been fairly canvassed. [B34]
- The Court concluded, for the purposes of the summary judgment application in Premier Modular, that the Trust had a real prospect of establishing a material breach of natural justice because the adjudicator had adopted a determinative contractual and factual basis which neither party had advanced or had a fair opportunity to address. [P35], [P39(ii)]-[P39(iv)], [P42]
- The different outcomes in BDP Construction Ltd v Cygnet Behavioural Health Ltd and Premier Modular Ltd v Maidstone and Tunbridge Wells NHS Trust were explained by the distinction between rejecting the parties’ competing cases and constructing a new determinative case. [B30], [B34], [B40]; [P35], [P39(iv)], [P42], [P48]-[P51]
Comment
Taken together, these judgments drew a clear distinction between permissible independent adjudicator reasoning and material procedural unfairness. An adjudicator was not required to choose between competing positions simply because those were the only positions advanced by the parties. Where neither party discharged the evidential burden, the adjudicator was entitled to conclude that neither case had been established. The existence of competing answers did not require the conclusion that one of them must be correct. [B27]-[B30], [B34]
In BDP Construction Ltd v Cygnet Behavioural Health Ltd, the Court held that the adjudicator remained within jurisdiction by concluding that neither party had established its asserted liquidated damages regime. The existence of two competing positions did not create a binary obligation requiring the adjudicator to select one of them. The failure of one party’s case did not automatically amount to proof of the other party’s case. [B25]-[B30]
The judgment also provided important guidance concerning burden of proof. The Court observed that the adjudicator had effectively accepted BDP’s criticisms of Cygnet’s contractual case whilst simultaneously accepting Cygnet’s criticisms of BDP’s contractual case. The result was that neither party established the contractual foundation necessary to support its position. The decision therefore reflected an assessment of evidential sufficiency rather than the introduction of a new factual or contractual basis. [B30]
The Court further distinguished between rejecting evidence already canvassed during the adjudication and determining a dispute on a new positive basis which neither party had advanced. The former was an ordinary exercise of adjudicative judgment. The latter might require the parties to be given an opportunity to make further submissions. [B34]
The position in Premier Modular Ltd v Maidstone and Tunbridge Wells NHS Trust was materially different. There, the Court concluded that the Trust had a real prospect of establishing that the adjudicator’s determination depended upon a contractual and factual basis which neither party had advanced and which had not been fairly canvassed. [P35], [P39(iv)], [P42]
The adjudicator’s conclusion that a revised programme had become the Accepted Programme formed the foundation of the compensation event finding notwithstanding that both parties had proceeded on the opposite basis. In those circumstances, the Trust had a properly arguable case that it had not been afforded a fair opportunity to address the determinative reasoning adopted by the adjudicator. [P30]-[P35], [P39(iv)], [P42]
The judgments therefore illustrated two sides of the same principle. An adjudicator may draw independent conclusions from the evidence, reject competing submissions and conclude that neither party had proved its case. An adjudicator may not, however, determine the dispute on a new and decisive contractual or factual basis which the parties had not been given a fair opportunity to address. [B27]-[B30], [B34]; [P35], [P39(iv)], [P42]
For practitioners, the practical lesson is clear. A shared dispute did not necessarily create a shared premise. Nor did the existence of two competing cases mean that one of them must succeed. The adjudicator’s task remained to determine the dispute referred on the basis of the evidence and arguments properly before the tribunal. The distinction between rejecting the parties’ competing cases and constructing a new determinative case ultimately explained the different outcomes in BDP and Premier Modular. [B25]-[B30], [B34], [B40]; [P42], [P48]-[P51]
